Enns Valley line
The 220-kV Enns Valley line running between Tauern and Weißenbach was commissioned in 1949. After more than 70 years of operation, it is planned to carry out a general overhaul of the line section between Wagrain and Weißenbach to make sure the line is ready to meet future demand and to ensure a secure supply of electricity in your region for decades to come.
General overhaul of the Enns Valley line
Upgrading the Enns Valley line will improve transmission capacity in APG’s grid and ensure energy security for your region. The upgrade is also a prerequisite for future projects, for example projects designed to support the Styrian energy networks. It will also play a major role in developments in the energy markets, such as additional integrations of renewable energies and new connections for industrial operations and power plant projects.
As a vital east-west connection in APG’s central grid, the upgraded line will make a significant contribution to the success of the energy transition. It will enable electricity from renewable energy sources to be transported from one end of Austria to the other, for use wherever it’s needed at the time. The general overhaul of the Enns Valley line will create the basis for sustainable development and the advance of the electrification of tourism, the economy, industry and society in your region – both now and in the generations to come.
Project ticker
All current information about the project at a glance.
Project ticker
All current information about the project at a glance.
- Update
APG in conversation: Citizens' information at Congress Schladming

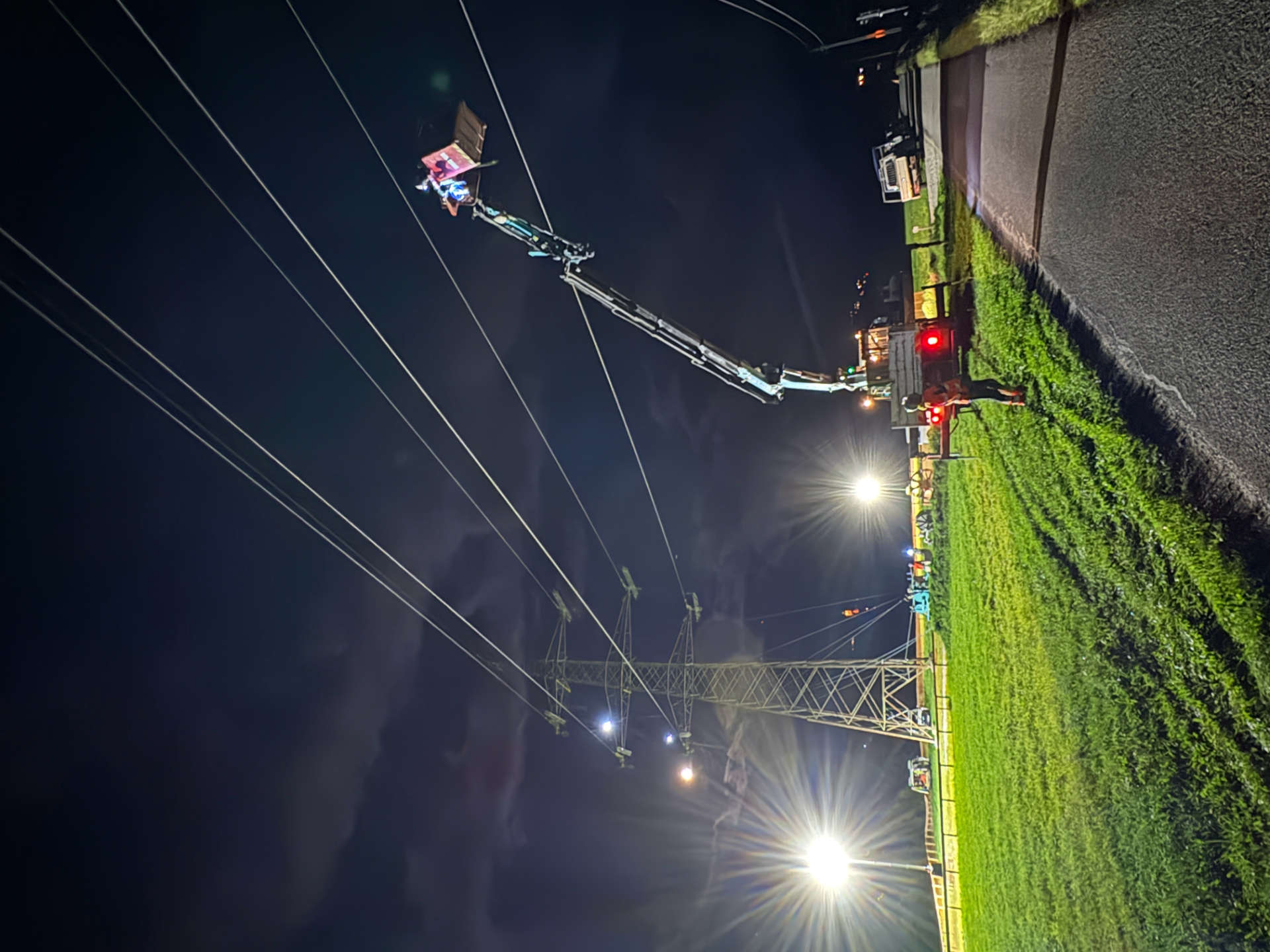

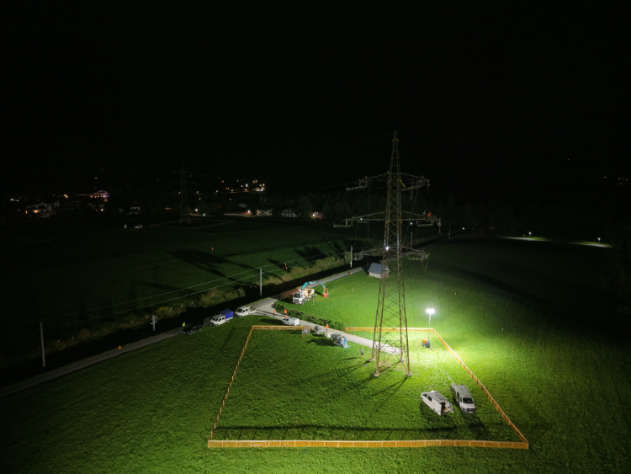

On 15 November, APG invited interested citizens to a project information event at the Congress Schladming concerning the general renewal of the Enns Valley pipeline. APG spent three hours talking to around 130 municipal representatives and property owners from the region.
After the project presentation, a large number of questions were answered individually and the various aspects of this project were discussed together with the representatives.
Citizens' information event cancelled at short notice for organisational reasons
The information event on the general renewal of the Enns Valley pipeline planned for today was cancelled at short notice in the early afternoon by the mayor of the municipality of Schladming, who is also the organiser, for organisational reasons. The entire APG team had already arrived in Schladming. In several discussions, the mayor was assured that the event would be held at a later date. The project for the general renewal of the 220 kV Enns Valley line is a central project for the secure supply of electricity in the economic and tourism region, as well as for the success of the energy transition and the achievement of Austria's climate targets. The APG team will discuss the further procedure with the mayor in the coming days and is always available for talks with citizens of the Greater Region and, of course, also for events.
2025-2027
234
Increasing electrification
Modern technology
73,2 km
approx. 175 million €
Project Roadmap
Construction phase
Implementation of the general renovation
StWG Decision
Vienna Provincial Administrative Court issues positive StWG ruling
Provincial Administrative Court
Hearings at the Administrative Court of Vienna (LVwG Wien)
StWG decision
Positive High Voltage Lines Act (Starkstromwegegesetz, StWG) decision from the Federal Ministry for Climate Protection, Environment, Energy, Mobility and Technology has been received.
Public negotiation
Public hearing according to the Heavy Current Routes Law (StWG)
Submission in accordance with the Heavy Current Routes Law (StWG)
The general renewal was submitted to the competent authority, the Federal Ministry for Climate Protection, Environment, Energy, Mobility, Innovation and Technology (BMK) according to StWG.
EIA determination notice
The decision of the Styrian provincial government, stating "no EIA obligation", became legally binding through the ruling of the Federal Administrative Court (BVwG).
Submission of EIA application
The general renovation was submitted to the Styrian provincial government for a determination of the EIA obligation.
Working toward a sustainable future
The foreseeable rise in consumption in the Styrian Enns Valley and in the Salzkammergut, Schladming-Dachstein and Gesäuse regions of Styria calls for a high-capacity electricity grid capable of meeting the demands of the future. In addition, the development of renewable energy will increase massively in the coming years with the goal of reaching the climate and energy targets set by the Austrian government. Increasing flows of energy will require a high-capacity electricity grid to distribute the sustainable electricity generated.
Energy market forecasts of increasing electrification clearly indicate the rising importance of having a high-capacity electricity grid, especially during the winter months. Maintaining a high level of supply quality is indispensable for the tourist centres in and around the Enns Valley.
Frequently asked questions - FAQ
In order to ensure a secure electricity supply in the region for the next generations, the Enns Valley pipeline is undergoing a general overhaul.
This means:
- Maintaining the voltage level of 220 kilovolts
- Modernisation of all components (pylons, foundations, earthing, fittings and cabling)
- Replacement of the existing single cable by a so-called 2-bundle: to increase the transmission capacity and at the same time reduce the line noise.
- Erection of the new masts at the same location with unchanged mast contact area
- Raising the masts by up to 10 metres: for an optimised immission load and increase of the clear passage height, e.g. for agricultural equipment
The construction phase will start in 2025 and end in 2027.
The investment volume is around 175 million euros
The sum stated is a planning figure. This planning figure is exposed to price changes on the world market, especially due to the long realisation period until 2027.
Total length of line: 73.2 km
- Of which in Salzburg: 16.9 km
- Of which in Styria: 56.3 km
Number of masts: 234 masts
An EIA determination procedure initiated by APG in June 2020 with the Styrian provincial government resulted in the conclusion that the general renewal of the line is not subject to an EIA and is therefore to be approved in accordance with the Starkstromwegegesetz (StWG). This decision was confirmed by the Federal Administrative Court (BVwG). At the end of 2021, the project was therefore submitted to the competent authority under the StWG.
The StWG hearing took place in Gröbming in July 2022. The positive StWG decision from the Federal Ministry for Climate Action, Environment, Energy, Mobility and Technology (BMK) has been available since October 31, 2022. With the positive decision of the Vienna Provincial Administrative Court on May 15, 2023, the StWG decision is legally binding.
Other specialist areas (e.g. nature conservation, forestry) will be examined at a later date in individual procedures.
A property can be occupied by our lines in the following ways:
- through a mast location
- by a span (in this case only the conductor cables and the associated servitude area pass over or close to the property)
- Forest encroachment
How the claimed agricultural and forestry areas are compensated is determined in a framework agreement that has been drawned up together with the Styrian Chamber of Agriculture. For the section of the powerline located in Salzburg, APG has drawn up a guideline that ensures equal treatment of all landowners in the entire pipeline area.
Identical to the framework agreement, it regulates the calculation of the amount of compensation for the easement agreements to be concluded with the landowners under private law and by mutual agreement.
The framework agreement applies equally to all land used and dedicated for agriculture and forestry. This ensures a uniform approach based on partnership. The equal treatment of all landowners is of great importance to APG.
For land that is not used for agriculture or forestry, there will be separate expert opinions to determine the amount of compensation.
Contact person
Stefan Walehrach
Project communication
Andreas Pischel
Project lead
